Oman Water Demand Forecasting
Daily 28 · Weekly 11 · Weekly 4

A review pack you can run yourself. Two bottle sizes, five main sales regions, one small model per region, plain-English method, honest numbers, the exact settings we used.

97.6%200ML weekly accuracy (11 weeks)
95.0%330ML weekly accuracy (11 weeks)
78.9%200ML daily accuracy (28 days)
77.4%330ML daily accuracy (28 days)

Accuracy = 100 × (1 − WAPE). Every number in this report comes from a real out-of-sample holdout, not from training data. DUQM and PDO are forecast but excluded from the headline score — Chapter 9 explains why, with numbers.

Contents

1The question we were asked

A water bottler in Oman sells two products — 24×330ML packs and 30×200ML packs — across 12 sales areas grouped into 7 regions. The factory, the trucks, and the warehouses all need to know how much water will be sold next, and where. We were asked two things:

  1. Daily: predict sales for each area for the next 28 days. Trucks load every morning. Target customers: distribution and drivers.
  2. Weekly: predict sales for each region for the coming weeks. Production runs, raw water, bottles, and warehouse space are planned weekly. Target customers: plant and supply chain.
Key idea A forecast is only useful if its accuracy is honest — measured on days the model has never seen. Everything in this pack is scored on a holdout at the very end of the history, and all the code that produced these numbers is in this folder so a reviewer can rerun it and get the same result.

2The data we were given

ProductRowsAreasRegionsHistory
24 × 330ML packs12,5681271 Jan 2021 → 24 Jan 2025
30 × 200ML packs14,5831171 Jan 2021 → 29 Jan 2025

Each row is one day, one area, one product: the day, the area, the region, and the cases sold. Four things about this file shaped every decision that followed.

2.1 There is not a single zero in the file

Across more than 27,000 rows, the smallest sale is 1 case. The source system only writes a row when something was sold. So a missing day usually means no sale happened — not that the data was lost. That single observation drives the filling policy in Chapter 3.

2.2 Some days are missing everywhere at once

20–23 July 2021 (Eid al-Adha) is missing in almost every area. 3 October 2021 (Cyclone Shaheen emergency holiday) is missing in several. Those are real closures, and the pattern repeats across both products — strong evidence they are genuine no-sale days, not broken records.

2.3 Friday means something different in every area

AreaFridays in historyFridays with no saleShare
IBRA21119793%
IBRI21115875%
SUR2127937%
NIZWA2127234%
SAHAM2133215%
AMERAT21310.5%

In IBRA, Friday is effectively a closed day. In AMERAT, Friday is a normal selling day. No single "Friday = zero" rule can be true for both. The model has to learn area × weekday, which is exactly what the features in Chapter 4 allow it to do.

2.4 One stretch of October 2021 looks like a data outage, not a holiday

11–15 October 2021: many normally busy 330ML areas (AMERAT, RUSAYL, MUSANNAH, SALALAH, SAHAM) go silent at the same time, while 200ML keeps selling. There is no public holiday in that window. Seventeen values are affected — a tiny number — and they are handled separately from real zero days (Chapter 3), with the assumption flagged in the data.

3How missing days were filled (the policy)

One rule for every blank would be wrong. A blank can mean "nobody ordered that day" (truly zero) or "the system lost that day" (unknown, not zero). Those two need opposite treatment. The policy below sorts every blank into one of four buckets.

Build a full calendar first sale → last sale, per area Shared closure day? Eid · Cyclone Shaheen → 0 Oct 11–15 2021 outage? same-weekday median, weight 0.25 Any other blank inside the span → 0 Flag every guess was_observed · is_imputed · weight Ready to train guesses never scored
SituationWhat we write into the dataAudit flag
Real sale (row exists in the source)Volume as-is, never touchedwas_observed = 1
Known shared closure (Eid, cyclone)Volume = 0is_closure = 1
330ML Oct 11–15 2021 outage (17 values)Median of the same weekday ±4 weeksis_imputed = 1, weight 0.25
Any other blank inside an area's active spanVolume = 0 (likely no-sale day)imputation_method = zero_no_sale
Before the first sale / after the last saleNo row createdinactive period, not a zero

The 330ML outage estimate, worked out

Take AMERAT on Monday 11 October 2021. The surrounding Mondays in the source file sold 716, 854, 833, 1732, 690, 912, 837, 653 cases. The median is 835. That 835 is written in, marked as an estimate, and given only a quarter of the training weight of a real row. Seventeen values were filled this exact way.

Filled calendars — the result of the policy
ProductTotal rowsReal salesNo-sale zerosClosure zerosEstimated
200ML16,37814,5831,750450
330ML17,69712,5685,0625017

That is 93% real data in the 200ML file and 71% in the 330ML file. The 330ML file is sparser because four of its areas sell very little (Chapter 9).

How the filled calendar splits between real rows and filled rows
Left: how the 200ML calendar is built. Right: how the 330ML calendar is built. Orange is the only guessed content in the whole project, and it is 17 values out of 17,697.
The most important courtesy in this pack Every filled row keeps its flag. When we score the model we use only observed rows (is_imputed = 0). A guess can help training; a guess is never counted as truth when measuring accuracy.

4How one forecast is made

The model is a small decision-tree ensemble called LightGBM, the same family of method that won the M5 retail forecasting competition. It is not a neural network and not deep learning. We train one model per region per product — ten small models in total in this pack — because each region has its own habits.

History features sales 1, 7, 14, 28, 56 days ago rolling mean / spread, 7 & 28 days how often it sells at all days since last sale Calendar features weekday, day, month, week weekend / Friday flags closure and event flags year trend Who / where area name region name (given as categories, so the model learns area habits) One model, one region, one product predicts cases for each day

4.1 The rule that keeps the score honest

All history features are built with a one-day shift — when the model predicts Tuesday, it is allowed to see Monday and earlier, never Tuesday itself. And the last 28 days of history are held out completely: the model never trains on them. The score in this report is only ever measured on those unseen days.

4.2 What "accuracy" means here (WAPE, in one minute)

We measure error with WAPE — the total absolute miss divided by the total actual volume.

Actual week:    1,000 cases
Forecast:         950 cases
Miss:              50 cases
WAPE  = 50 / 1000 = 5%      Accuracy = 100% − 5% = 95%

WAPE is a percentage of the whole, so it does not punish big regions and small regions equally per case — it asks "of all the water we shipped, how much did we misjudge?" That matches how the business thinks about a plan.

4.3 The exact settings used (winners only)

Each region's best settings are stored in params/best_params_200ML.json and params/best_params_330ML.json so the reviewer runs exactly what produced these numbers.

Product / regionModelLearning rateLeavesTweedie power
200ML CAPITAL, Batinah, SharqiyahTweedie0.05 – 0.115111.05 – 1.18
200ML Dhofar, Al DakhiliyahTweedie0.03 – 0.07127 – 5111.14 – 1.49
330ML CAPITALPoisson0.1063
330ML Batinah, Dhofar, Sharqiyah, Al DakhiliyahTweedie0.02 – 0.11127 – 5111.29 – 1.53

Tweedie and Poisson are count-friendly objectives: they suit demand data with many small days and occasional big ones, and cannot predict negative cases. The model stops training automatically when the last 28 days of training stop improving (early stopping).

5Daily results and the daily ceiling

Daily accuracy for the next 28 days, measured on unseen days, five regions:

Region200ML330ML
CAPITAL86.6%84.2%
Dhofar78.8%76.1%
Batinah76.2%69.9%
Sharqiyah63.0%45.4%
Al Dakhiliyah59.6%57.1%
All five together78.9%77.4%
200ML daily 28-day forecast vs actual
200ML — one panel per region, because each region runs its own plant and trucks. Each panel draws that region's daily total; the percentage in its title is that region's own daily accuracy, the same number as in the table above.
330ML daily 28-day forecast vs actual
330ML — same per-region view for the other product. Sharqiyah's panel shows the hardest region honestly at 45.4%: no country total hides it.

5.1 Where the daily error comes from

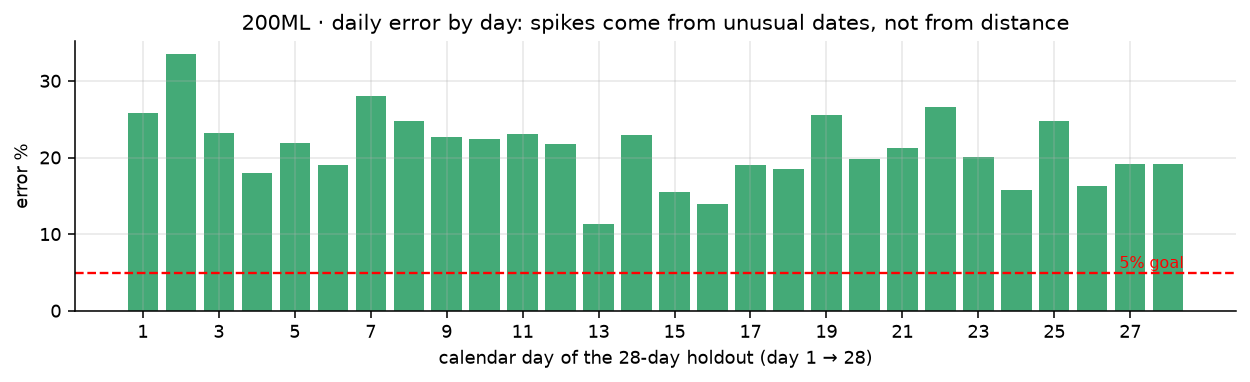

200ML daily error per day of the holdout
200ML — error per day of the holdout. The spikes sit on unusual dates, not on far-away dates. In this holdout the model still sees real history for every day (a "re-forecast each morning" view); in a full 28-day rollout the far days would also be building on predicted history, which would add more error, not less.

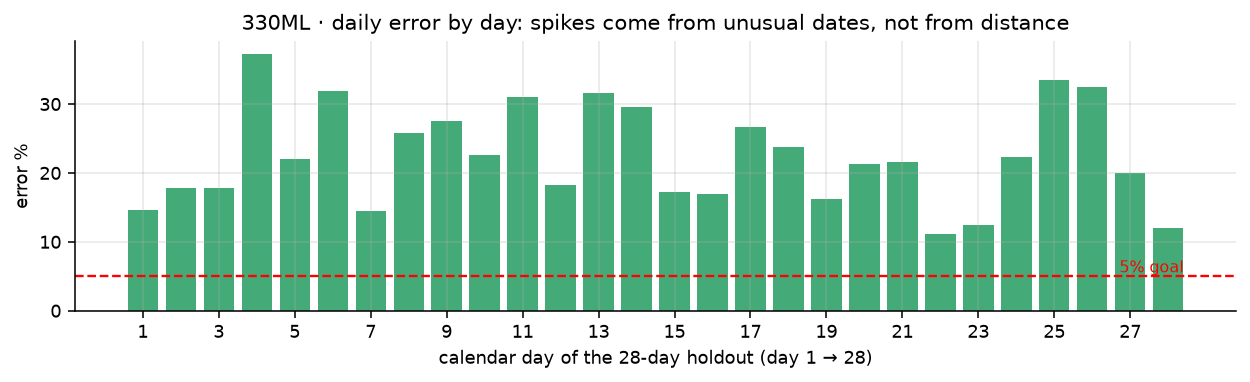

330ML daily error per day of the holdout
330ML — same pattern. Day 1 is sometimes worse than day 28, which proves the point: daily error is driven by what that particular day was, not by how far ahead it is.

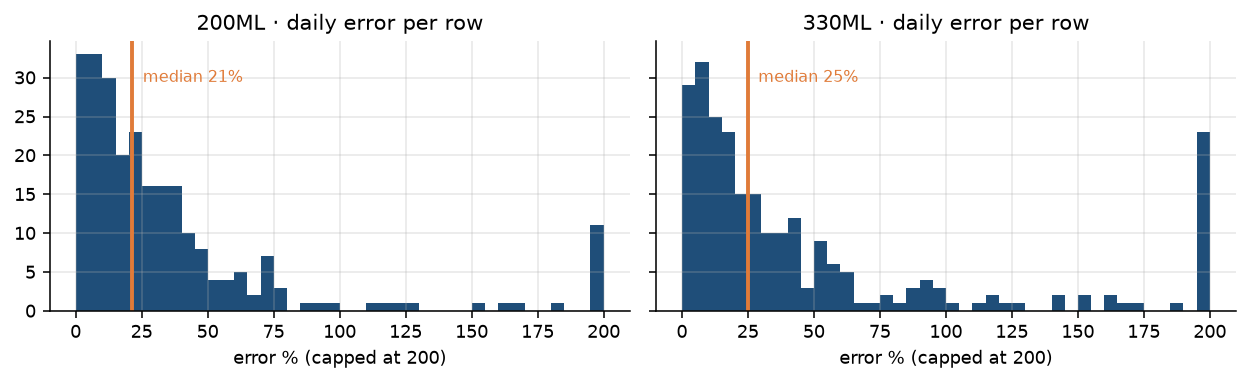

Distribution of daily errors per row
Half of all daily rows land within the orange line (the median error). The long right tail is the price of a single unusual day.
Why daily cannot reach 5% error with this data
  1. A single day is one lumpy decision. A shop that orders 0 on Monday and 500 on Tuesday makes the day-to-day line jump. History cannot know which Tuesday the truck arrives; the model splits the difference and takes the error.
  2. Friday has five different meanings. Closed in IBRA, normal in AMERAT. The model learns this, but any single surprise Friday is a large miss on a single day.
  3. Holidays stop trucks, not thirst. Eid and cyclone days are zero sales but not zero demand. And nothing in the file explains the biggest jumps — no promotions, no price, no stock-out records, no delivery routes.
  4. Small denominators explode percentages. Missing 30 cases in an area that sells 60 that day is a 50% error for that row, even though the business barely notices 30 cases.
  5. Four years is a short teacher. Ramadan drifts about 11 days every year, so each area's Ramadan pattern has been seen only four times. That is thin evidence for such a strong event.
Weather (temperature, humidity, rain) was also tested and added no measurable lift, so the final models do not use it.

6Weekly results

The same ten models, the same forecasts — simply added up over Monday-to-Sunday weeks before scoring. Two horizons were tested: the last 11 full weeks, and the last 4 weeks.

6.1 Eleven weeks

Region200ML330ML
CAPITAL97.3%93.9%
Batinah95.7%89.6%
Dhofar91.5%91.3%
Sharqiyah90.5%87.8%
Al Dakhiliyah84.7%84.0%
All five together97.6%95.0%

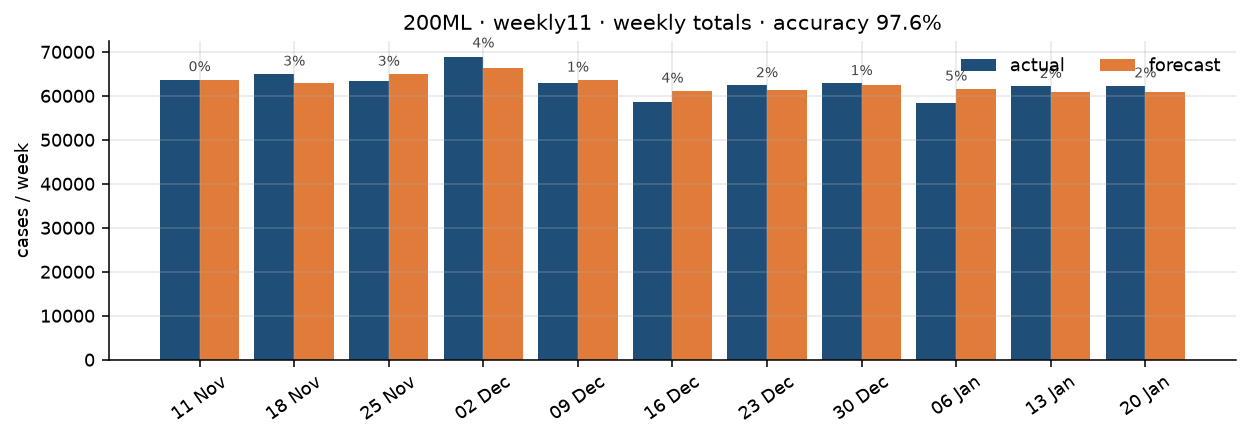

200ML weekly 11 weeks forecast vs actual
200ML — weekly totals, 11 weeks. Percentages above each pair are that week's error (actual vs forecast).

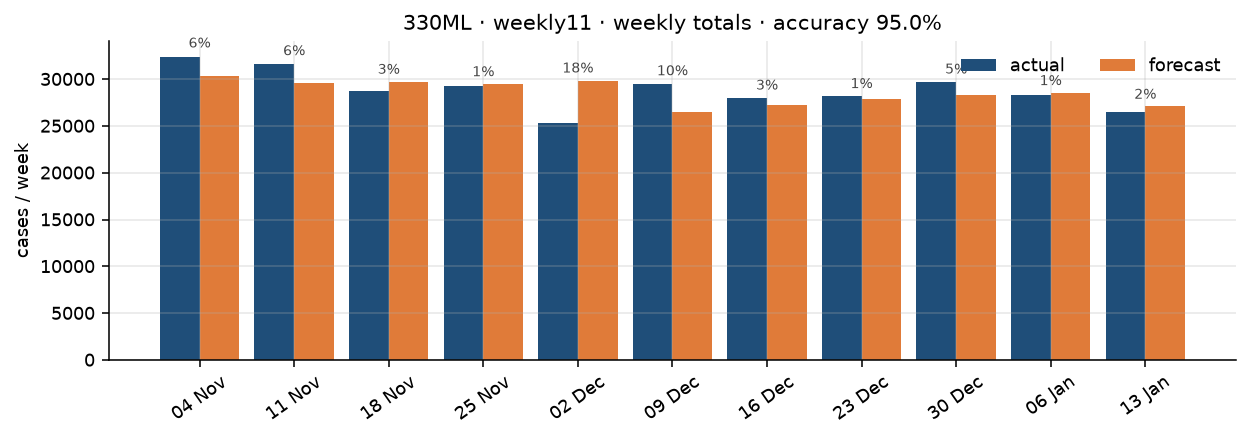

330ML weekly 11 weeks forecast vs actual
330ML — weekly totals, 11 weeks. Even the harder product lands on the bar most weeks.

6.2 The last four weeks

Same models, retrained on history ending four weeks ago — a check that the accuracy is not a lucky artifact of one long window.

Region200ML330ML
CAPITAL97.0%92.8%
Batinah94.2%89.2%
Dhofar92.5%88.7%
Sharqiyah90.8%88.4%
Al Dakhiliyah82.7%92.0%
All five together96.4%94.8%

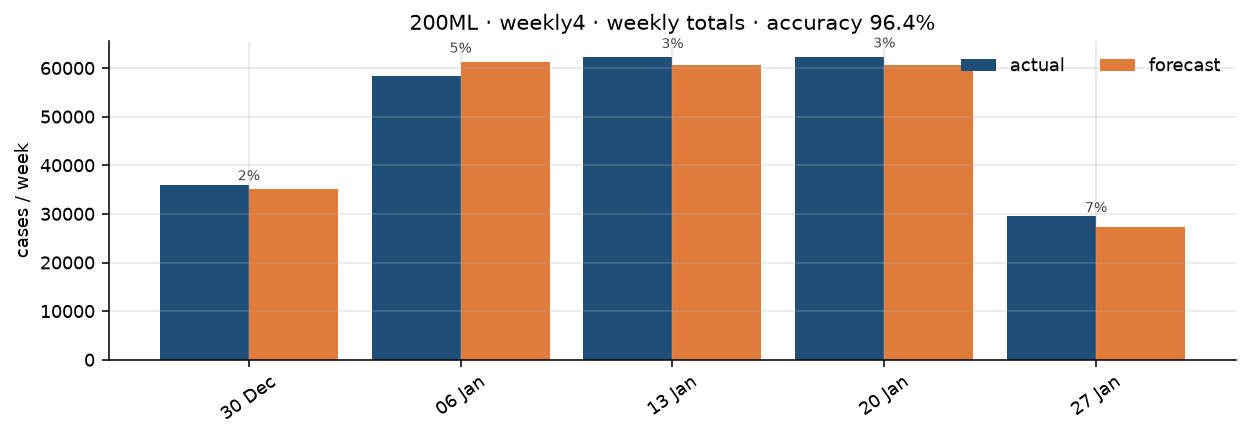

200ML weekly last 4 weeks forecast vs actual
200ML — last four weeks, week by week.

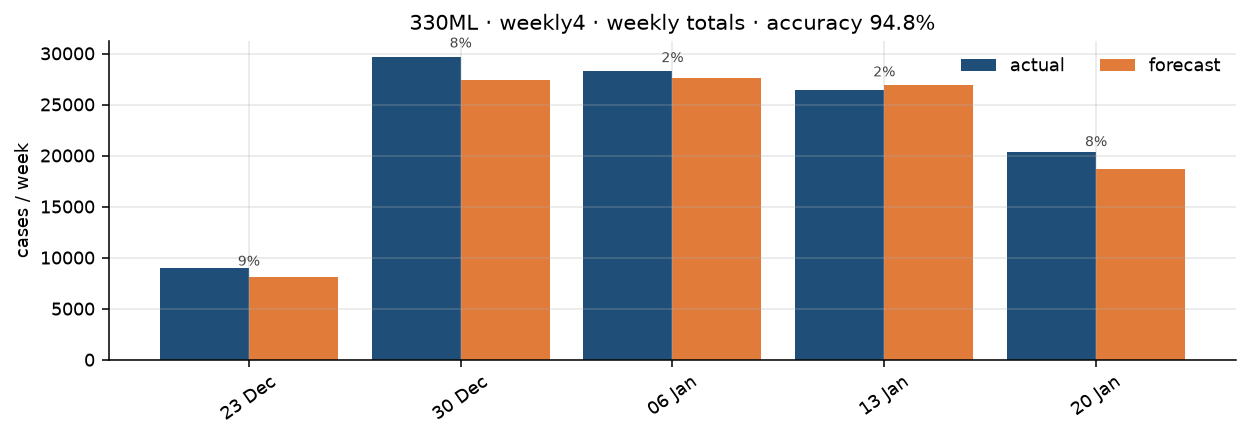

330ML weekly last 4 weeks forecast vs actual
330ML — last four weeks. The four-week view is the closest to live conditions.

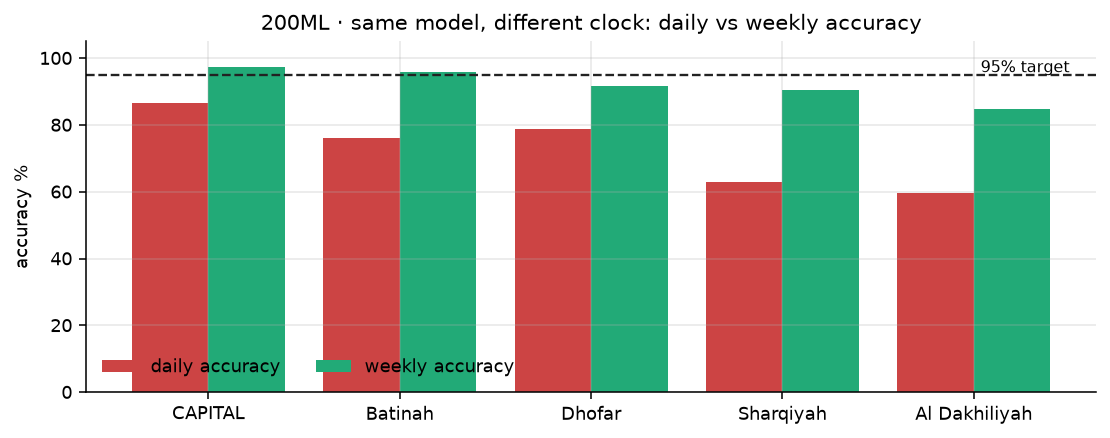

200ML daily vs weekly accuracy per region
200ML — the same models, two clocks. Weekly clears or approaches the 95% line in every region except Al Dakhiliyah.

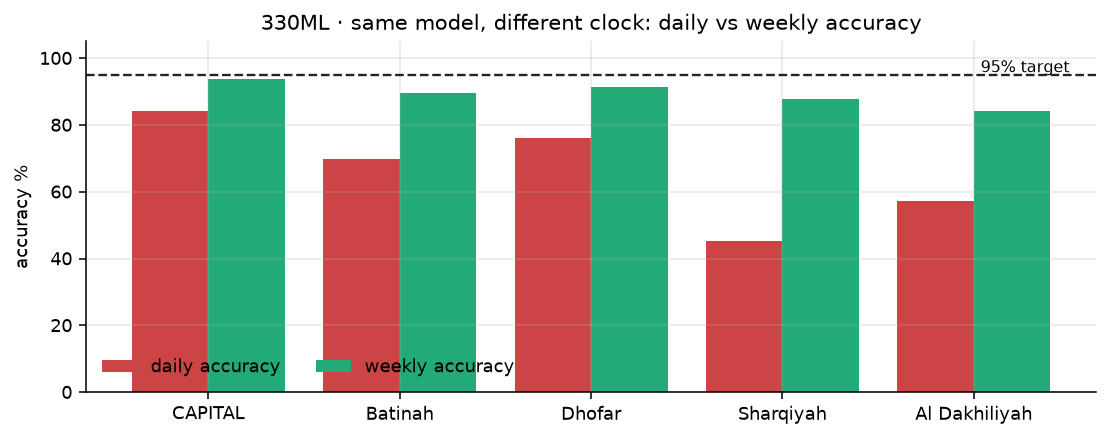

330ML daily vs weekly accuracy per region
330ML — the same story. Nothing about the model changed between the red and green bars; only the window the numbers are added over changed.

7Why weekly beats daily

This is the single most important idea in the pack, and it is not a model trick — it is arithmetic.

One week of one area — actual vs forecast MonTue WedThu FriSat Sun Day 2: forecast 40, actual 68 — a 41% miss. Week total: 322 vs 325 — only a 1% miss. Daily: every bar is judged alone, so every wobble is an error. Weekly: the errors point in opposite directions, cancel out, and only the level that matters to the business survives.

Over a week, a slow Monday is usually paid back by a busy Tuesday. Adding the days together before comparing means the random part of the wobble cancels while the real level remains. The model was never bad at the level of demand — it was bad at guessing the exact day. The weekly number uses what the model is actually good at.

In one sentence Daily asks "will it be 120 or 160 cases on the 14th?" — weekly asks "will this region move about 1,000 cases this week?" The second question matches both the model's strength and the way a factory actually plans.

8What each forecast is for (business)

DecisionClock to useWho uses itWhy that clock
How much to produce next week (raw water, bottles, line time)WeeklyPlant, production planningRuns are batched weekly; a day-level miss is irrelevant to a weekly run. 95–98% is enough to plan materials and shifts.
Warehouse space and stock transfer between regionsWeeklySupply chainReplenishment lead times are measured in weeks; weekly totals set safety stock.
Truck capacity and fleet allocation per regionWeeklyLogistics planningFleet size is re-planned weekly, not daily.
Which shops and areas each truck serves tomorrowDailyDistribution, driversA driver needs a number per area per day to load the right quantity; 78% daily accuracy is the honest guidance range, not a promise per shop.
Short shelf-life urgent replenishmentDailyArea supervisorsDaily view shows the next few days; supervisors adjust with local knowledge.
How to read daily numbers honestly Quoted daily accuracy is the share of total volume forecast correctly across a region — not the chance that any one shop's day is exact. Use daily forecasts to plan the size of tomorrow's load, and weekly forecasts to plan what the factory makes. If a decision costs real money, make it on the weekly clock and use the daily clock only to distribute it.

9Why DUQM and PDO sit outside the headline

DUQM, DUQUM PDO and PDO are real customers, and the models do forecast them. They are left out of the headline accuracy for one reason: their history is too thin to measure with a percentage fairness.

AreaProductDays with salesActive daysCoverage
PDO200ML1501,48010%
DUQM330ML3621,42725%
DUQUM PDO330ML861,4456%

When a region sells in only a handful of days, a weekly percentage error is divided by a tiny number. Predicting 40 cases in a week when the truth is 10 is reported as a 300% error — a scary number for a 30-case miss. Their absolute misses are small: 200ML PDO's typical daily miss is about 3 cases. That is why the pack reports them separately, with the honest note that a percentage cannot describe them well.

The effect on the headline, stated openly
Headline200ML330ML
Weekly 11-week accuracy, five main regions97.6%95.0%
Same, with DUQM and PDO added back97.6%93.5%

200ML barely moves because DUQM and PDO sell almost nothing there. 330ML drops 1.5 points because two sparse sites with wild percentages are enough to pull the average down. Nothing about the other five regions changed.

10Reproduce everything yourself

CPU only. No API keys, no internet, no special hardware. From this folder:

pip install -r requirements.txt
python3 daily28/train.py  && python3 daily28/predict.py    # daily 28-day holdout
python3 weekly11/train.py && python3 weekly11/predict.py  # 11-week window
python3 weekly4/train.py  && python3 weekly4/predict.py   # last 4 weeks
python3 make_charts.py                                      # rebuild every chart
PathWhat it is
data/*_daily_calendar_filled.csvThe filled calendars with every flag intact (was_observed, is_imputed, training_weight)
params/best_params_*.jsonThe exact settings that produced the numbers in this report
daily28/, weekly11/, weekly4/train + predict scripts, saved models
predictions/Row-level actual-vs-forecast CSVs you can audit or chart
charts/Every figure in this report, regenerated from the predictions
Rerun creates the same numbers The scripts fix the random seed and use the identical data and settings, so a reviewer on any machine gets the same accuracy figures shown here, up to tiny library-version differences.

11Glossary and straight answers

TermMeaning in this pack
WAPETotal absolute error ÷ total actual volume. So "5% WAPE" means "we misjudged 5% of the water shipped".
Accuracy100% − WAPE. Used everywhere in this report.
HoldoutThe last days of history, removed from training, used only to score.
LagSales from N days ago, e.g. lag_7 = the same weekday last week.
Rolling meanThe average of the previous N days — a smooth memory of recent level.
Tweedie / PoissonObjective functions for count data (cases sold). They fit demand with many small days and occasional large ones and can never predict negative sales.
LightGBMA decision-tree ensemble; the same family that won the M5 retail forecasting competition.
Early stoppingThe model keeps a small internal check window and stops improving when it starts to memorize.

Straight answers

Why not deep learning? Four years of daily data across a handful of areas is small. Tree ensembles have repeatedly matched or beaten neural networks on this kind of tabular, intermittent demand — including in the M5 competition this project takes its recipe from. Neural networks would add complexity without evidence of gain.

Can daily accuracy ever reach 95%? Not with this data. To get there the model would need to know the events that actually move a single day: promotions and prices, out-of-stock days, delivery schedules, and a confirmed closure calendar. With those inputs a daily model could improve; without them it is guessing at the noisiest part of the signal. Weekly already crosses 95% for four of five regions without any of that.

Does weather help? It was tested properly (temperature, humidity, rain, heat flags from ERA5 reanalysis). It produced no measurable lift on either product, so it was left out to keep the models simple. It can be revisited when more history exists.

What should we do next? Two things pay first: get the promotion and stock-out history from the business to attack the daily error where it is largest, and keep the weekly forecast as the production number, since weekly accuracy is already at the level the plant needs.
